1. Can You Rebuild under Existing Property Restrictions?

Qualifying properties may receive expedited approval despite certain existing zoning restrictions. California Executive Order N-4-25 and subsequent orders suspend some CEQA and Coastal Act requirements for eligible January 2025 wildfire rebuilding, but building and safety standards remain applicable.
Like-for-Like Rebuilding and Size Limits

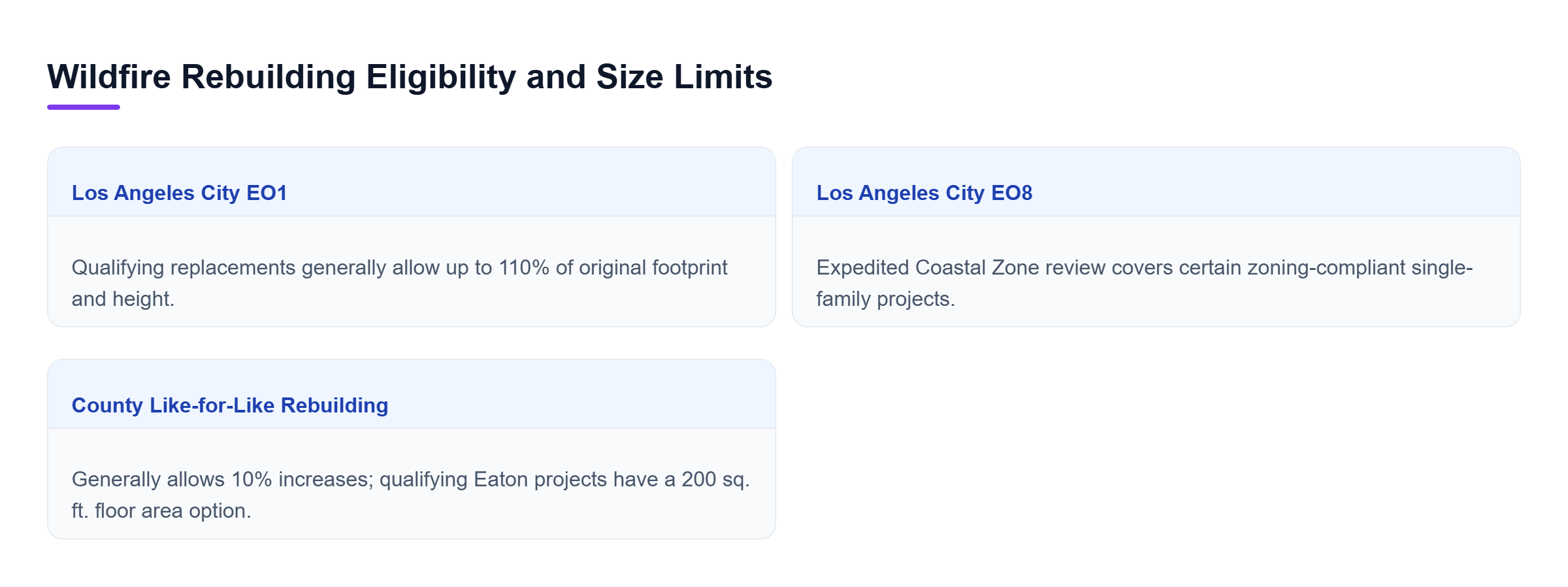

Los Angeles City Emergency Executive Order 1 (EO1) generally limits qualifying replacement structures to 110% of the original footprint and height, not total floor area. In unincorporated County areas, like-for-like rebuilding generally allows increases of up to 10% in size, floor area, footprint, or height. Qualifying Eaton Fire projects may increase floor area by 200 square feet or 10%, whichever is greater. The 200-square-foot allowance does not apply to height. Previously lawful nonconforming conditions may remain, subject to applicable requirements.
Changes in Use, Density, or Design
Additional units, major expansions, or changes in use may require separate approvals. City EO8 provides expedited review for certain zoning-compliant single-family rebuilding projects in the Coastal Zone. ADUs follow separate rules, while bluff setbacks, biological resources, easements, and recorded restrictions may limit construction.
2. Where Must Owners Apply for Rebuilding Permits?
The property's jurisdiction determines the permitting authority. Other incorporated cities administer their own procedures rather than automatically following City or County rebuilding orders.
Los Angeles City Building and Planning Review
The Los Angeles Department of Building and Safety (LADBS) reviews construction permits, while City Planning handles applicable zoning and coastal clearances. Palisades Fire owners may use designated rebuilding assistance services. Prior permits, property records, and proposed plans help establish EO1 or EO8 eligibility.
Unincorporated County Rebuilding Applications
Owners in unincorporated areas such as Altadena may apply through EPIC-LA or County One-Stop Permit Centers. County like-for-like applications generally must be submitted within two years of the emergency declaration, subject to possible extensions. Issued building permits generally expire if construction does not begin within 12 months.
Plans may be submitted before debris clearance finishes, but required clearance must precede permit issuance. Private cleanup requires applicable debris-removal permits and clearance, while government-program participants should retain completion documentation.
3. Which Property Records and Payments Affect Rebuilding?
Owners must establish the former building's lawful characteristics and determine whether insurance proceeds or mortgage obligations restrict construction funding.
Proving the Previous Building'S Size and Use
Prior permits, approved plans, Certificates of Occupancy, assessor records, and photographs may establish the structure's location, dimensions, and use. Previously lawful nonconforming conditions require evidence of their legal status. When original plans are missing, authorities may consider other reliable records.
Insurance Proceeds and Mortgage Restrictions
Mortgage lenders may hold insurance proceeds in escrow and release funds as reconstruction progresses. Loan documents and applicable law govern disbursement conditions, while California Civil Code §2954.85 addresses interest on covered insurance proceeds held by lenders.
On October 15, 2026, California's BCSA and DFPI announced reporting requirements and investigations concerning delayed wildfire insurance disbursements. This action does not guarantee immediate payment. Owners facing delays should request written release conditions and explanations of withheld funds. Coverage disputes may require a separate insurance claims review.
4. What If a Rebuilding Application Is Rejected?
Plan-check corrections differ from formal denials. Missing engineering documents may require revised plans, while zoning objections may require additional approvals or administrative appeals.
Permit Corrections and Administrative Appeals
Los Angeles City Planning accepts qualifying entitlement appeals online or through Development Services Centers. Building and Safety appeals under LAMC §12.26(K) require in-person filing at designated centers. Unincorporated County planning appeals follow County Code Title 22, with the decision type determining the reviewing authority and filing deadline.
Judicial Review and Private Property Disputes
Certain final administrative decisions may qualify for review in Los Angeles County Superior Court after required administrative remedies are exhausted. Code of Civil Procedure §1094.5 applies to qualifying administrative adjudications, not every permit denial.
Permits also do not override private easements, covenants, or construction contracts. Owners should preserve agency decisions, plans, invoices, and correspondence when evaluating a construction dispute.
5. Frequently Asked Questions
Can I Live in an RV on My Property While Rebuilding?
Qualifying Los Angeles City residential properties may accommodate temporary RVs, mobile homes, or manufactured homes for up to three years or while an active rebuilding permit remains effective, whichever is longer. Applicable utility and safety standards still apply.
Unincorporated County properties require separate temporary housing approval. Eligible displaced residents may receive permits generally lasting two years from the emergency declaration, with up to three one-year extensions when approved. Site clearance and required utilities must be addressed before occupancy, and temporary housing must be removed within the applicable period after the replacement dwelling receives a Certificate of Occupancy.
Can I Sell My Fire-Damaged Property Instead of Rebuilding?
Yes. Owners may sell without rebuilding, subject to mortgages, liens, disclosures, and contractual obligations. California Civil Code §2079.26, enacted through AB 851, restricts unsolicited residential purchase offers in specified wildfire-affected ZIP codes through December 31, 2026. Offers following a public indication of willingness to sell, such as a listing or sale sign, generally fall outside the prohibition.
For covered transactions, buyers and sellers must sign an attestation confirming the agreement did not result from a prohibited offer. The buyer must attach it to the recorded conveyance.
6. When Rebuilding Plans Face a Legal Barrier
Permit denials, disputed pre-fire building status, delayed insurance proceeds, and private property restrictions can affect reconstruction. Owners should preserve permits, agency decisions, property records, loan documents, and contracts before pursuing an appeal or committing to construction expenses. An attorney can evaluate applicable administrative and contractual remedies when these issues remain unresolved.
20 Oct, 2026
