A Shipbuilding and Construction Claim Arbitration Attorney Can Help

Practice Area:Corporate

A New York attorney can organize technical claims, select arbitral rules, preserve remedies, and prepare an enforceable award.


Shipbuilding and construction disputes rarely turn on one document. Payment records, change orders, schedules, design documents, expert findings, and the arbitration clause shape the claim. Early review can distinguish maritime from nonmaritime issues, identify governing rules, preserve evidence, and build a practical path from negotiation to award enforcement.


1. Identify the Contract and Legal Framework before Filing


Separate Vessel Construction from Maritime Services

Under longstanding U.S. .dmiralty principles, a contract to build or complete a vessel is generally nonmaritime, while a contract to repair an operating vessel may be maritime. Even a nonmaritime shipbuilding agreement may fall under the Federal Arbitration Act if it evidences a transaction involving interstate or foreign commerce. An early admiralty and maritime law review helps identify the correct jurisdictional basis instead of assuming that every vessel-related dispute belongs in admiralty.

Read the Arbitration Clause As a Road Map

The clause should be checked for its scope, seat, governing law, institution, rules, tribunal size, language, and method of selecting arbitrators. It may adopt SMA Maritime Arbitration Rules, AAA Construction Industry Arbitration Rules, JAMS rules, or ICDR rules. The clause should also address consolidation, joinder, interim relief, fee allocation, confidentiality, and the form of the award. If negotiation or mediation is a condition precedent, the parties should satisfy it or expressly waive it before filing.

Preserve Liens and Other Parallel Rights

Starting arbitration does not automatically extend statutory lien, bond, insurance, or warranty deadlines. For qualifying New York real-property construction work, Lien Law § 35 provides that filing a notice of lien does not waive a contractual arbitration right. Eligibility, notice, filing, and foreclosure requirements still need separate review. The arbitration demand should be coordinated with any mechanic's lien, payment-bond, insurance-notice, or provisional-remedy strategy before a deadline expires.

Clause TermQuestion to ResolvePractical Effect
Seat and governing lawWhere is the arbitration legally based, and which substantive law applies?Shapes court supervision, procedure, and contract defenses
Arbitration rulesWhich institution and version of its rules govern?Controls filing, discovery, emergency relief, and fees
TribunalIs one arbitrator sufficient, or does the dispute require three?Affects technical expertise, scheduling, and cost
Joinder and consolidationCan related contracts and parties be heard together?Reduces the risk of inconsistent decisions

The project label does not decide the governing law. The Federal Arbitration Act generally governs written arbitration agreements in maritime transactions and contracts involving interstate or foreign commerce. CPLR Article 75 may govern New York state-court applications where applicable, subject to federal preemption. The arbitration seat and substantive contract law remain separate choices.



2. Build the Claim Around the Project Record


Payment and Change Order Claims

Payment claims should reconcile the contract price, payment applications, approved work, retainage, credits, and amounts received. Change order disputes require the directive, notice, pricing support, schedule effect, and proof of authorization. Under New York law, a true pay-if-paid clause that shifts the risk of owner nonpayment to a subcontractor is generally void, while a pay-when-paid clause may set the time for payment. A valid choice-of-law clause can change that analysis. A focused construction dispute review can also identify missing approvals or inconsistent records before positions harden.

Defect, Design, and Material Claims

A technical claim should distinguish design responsibility from fabrication, installation, inspection, and maintenance. Specifications, drawings, requests for information, inspection reports, testing data, photographs, classification-society records, and preserved components may establish the cause and scope of a defect. Experts should inspect disputed work before repair or removal when possible. The damages analysis must also account for warranties, repair obligations, exclusions, liability caps, and any agreed remedy that limits recovery.

Delay, Force Majeure, and Supply Chain Claims

A delay claim needs more than proof that completion occurred late. Updated schedules, daily reports, procurement records, correspondence, and critical-path analysis should connect each event to project completion. The contract determines whether force majeure permits time, money, or neither. A claimant should also address concurrent delay, mitigation, notice, material substitutions, and whether the disrupted supply source was actually required by the contract.

Arbitrators need a clear account of the contractual duty, the project event, and the resulting loss. Contemporaneous records should connect liability, causation, and damages so the tribunal does not have to reconstruct the job from scattered files.



3. Manage the Arbitration from Notice to Enforcement

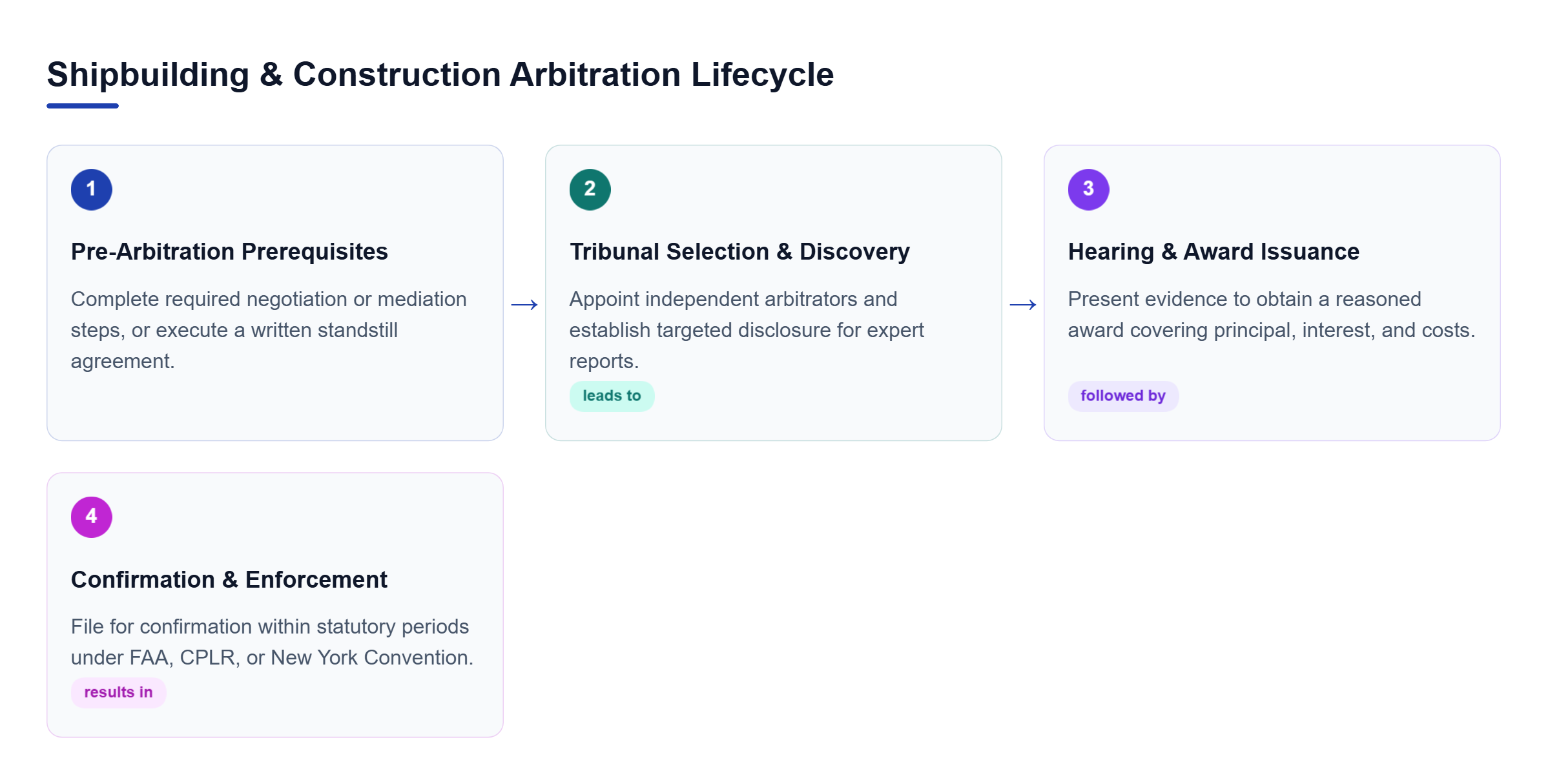

Diagram: Linear workflow showing pre-arbitration prerequisites, arbitrator selection, case hearing, and post-award judicial confirmation.
Diagram: Linear workflow showing pre-arbitration prerequisites, arbitrator selection, case hearing, and post-award judicial confirmation.

Arbitration lets parties select technically informed decision-makers and tailor disclosure, but it is not automatically faster, private, or less expensive. The governing rules and procedural order shape filing, tribunal appointment, discovery, the hearing, and the award, while judicial review remains limited.


Use Negotiation and Mediation without Losing Time

Pre-arbitration discussions work best when each party receives a concise claim chronology, contract basis, damages calculation, and supporting documents. A multi-tier clause may require project-level negotiation, executive review, or mediation before arbitration. Settlement discussions do not automatically suspend contractual or statutory deadlines. If the parties need more time, they should consider a written standstill agreement that identifies the claims and the deadlines being addressed.

Select Arbitrators and Control Expert Discovery

Technical knowledge matters, but independence, availability, case-management style, and disclosure history matter as well. The tribunal should receive a workable plan for document exchange, electronic records, depositions, inspections, and expert reports. Targeted discovery often serves the case better than copying court litigation. Confidentiality is not automatic in every arbitration, so the agreement, governing rules, and any protective order should cover sensitive pricing, designs, trade secrets, and vessel data.

Prepare the Award for Confirmation and Enforcement

The requested relief should identify principal amounts, interest, fees, declaratory relief, and arbitration costs. If the parties want a reasoned award, the clause or procedural order should say so. Judicial review is not an ordinary appeal. FAA § 12 requires service of notice of a motion to vacate, modify, or correct within three months after the award is filed or delivered. Where FAA § 9 applies, a party may seek confirmation within one year after the award is made. CPLR § 7511 generally allows 90 days after delivery to seek vacatur or modification, while CPLR § 7510 requires an application to confirm within one year after delivery. For an award governed by the New York Convention, 9 U.S.C. § 207 provides a three-year confirmation period. A post-award judgment enforcement plan should identify the debtor, assets, forum, and possible recognition defenses.


4. Frequently Asked Questions


Can related shipyard, supplier, and design claims be combined in one arbitration?
Only if the agreements and rules permit it, the parties consent, or applicable law supplies a basis to bind a nonsignatory. Similar facts alone do not give a tribunal authority over an additional party or a dispute governed by an incompatible clause.


Does choosing New York as the arbitration seat make New York law govern the contract?
Not necessarily. The seat determines the arbitration's legal home and the courts that may supervise it, but the contract may select different substantive law. The arbitration clause and governing-law clause should be read together.


Can a party obtain emergency relief before the tribunal is formed?
Possibly. Institutional rules may provide an emergency arbitrator, and applicable law may allow court-ordered provisional relief. Availability depends on the clause, rules, requested remedy, and whether court involvement is consistent with the agreement.


Can an award be enforced against assets outside New York?
Potentially. A domestic award generally must first be confirmed as a judgment before ordinary collection tools apply. International enforcement may proceed under the New York Convention, subject to jurisdiction, service, asset location, and limited recognition defenses.



5. Discuss a Shipbuilding or Construction Arbitration Claim with Sjkp


SJKP's attorneys help businesses review arbitration clauses, preserve project records, develop technical claims and defenses, coordinate experts, and plan award enforcement. Contact SJKP to evaluate the contract, governing rules, notice requirements, parallel remedies, and immediate deadlines before missing records or expired rights narrow the available strategy.
