California Land Use Attorney Checks Permitted Uses and Approvals

Practice Area:Real Estate
Jurisdiction:California


A California land use attorney compares a proposed use with zoning rules to determine whether a permit, conditional approval, variance, or rezoning is needed.

An existing building or business does not establish that a proposed use is lawful. Before purchasing or leasing, check zoning against approved plans and any violation notices. Government Code § 65906 bars a variance from authorizing a use prohibited in the zone.



1. Verify That the Proposed Use Is Legally Allowed


Ownership does not confer a right to enlarge a building or change its use. The rules for the specific parcel determine what is permitted.


Identify the City, County, and Governing Plans

Cities generally regulate zoning within their boundaries, while counties govern unincorporated areas. Use the parcel number to find the jurisdiction, zoning ordinance, general plan, and any specific plans or overlays. An assessor's land-use label or listing description is not a substitute for adopted zoning.

Under Government Code § 65860, zoning generally must conform to the general plan, but a plan designation is not itself a development permit. Check allowed uses, density, setbacks, height, parking, and design requirements.

Compare the New Proposal with Past Approvals

Specify the activity, floor area, units, and access needs. Compare the proposal with prior permits, applicable occupancy records, approval conditions, and enforcement notices. A lawful existing use may still have expansion limits. A prior approval may also restrict operating hours or occupancy after a sale.

During commercial property acquisition, distinguish the seller's operations from the buyer's plans. A deed or clear title report does not establish zoning compliance.


2. Choose the Approval That Matches the Obstacle


Diagram: Decision tree mapping development barriers to ordinary permits, conditional use permits, variances, and rezoning.
Diagram: Decision tree mapping development barriers to ordinary permits, conditional use permits, variances, and rezoning.

The barrier to development determines the approval route. Compliance with objective rules differs from discretionary permission or a change to zoning.


Distinguish Ordinary Permits from Conditional Uses

A permitted use may still need building or grading permits. A conditional use permit (CUP) applies where local rules expressly allow that use subject to findings and conditions, often after a hearing. Confirm who decides the application and whether public notice is required.

Project PositionPossible RouteWhat the Agency Examines
Use allowed and standards satisfiedApplicable building or planning permitsCompliance with governing standards
Use listed as conditionalCUPRequired findings and proposed conditions
Allowed use hindered by unusual parcel conditionsVarianceStatutory property-specific hardship
Proposed use prohibited by zoningProject revision or rezoningApplicable legislative and planning rules

Use allowed and standards satisfied

  • Possible RouteApplicable building or planning permits
  • What the Agency ExaminesCompliance with governing standards

Use listed as conditional

  • Possible RouteCUP
  • What the Agency ExaminesRequired findings and proposed conditions

Allowed use hindered by unusual parcel conditions

  • Possible RouteVariance
  • What the Agency ExaminesStatutory property-specific hardship

Proposed use prohibited by zoning

  • Possible RouteProject revision or rezoning
  • What the Agency ExaminesApplicable legislative and planning rules

Several approvals may be necessary for the same project. None is guaranteed.

Apply the Limits on Variances and Rezoning

Under Government Code § 65906, a variance requires special property circumstances, such as unusual shape or topography, that deny privileges enjoyed by comparable parcels. Cost alone is insufficient. Survey measurements and nearby comparable parcels may help establish the required distinction.

A variance cannot authorize a prohibited use. CUPs follow different rules. Rezoning changes the underlying regulations through legislative action. Compare that uncertain process with revising the project to fit an allowed use.


3. Test State Housing and Environmental Requirements


State housing laws may affect local density limits. Environmental rules can require separate review before approval.


Check State Rules before Assuming Rezoning Is Necessary

Government Code § 65915 provides qualifying housing projects with density bonuses and possible incentives, concessions, or waivers. Eligibility depends on the proposed units and statutory conditions.

Government Code § 65860(c)(2) also provides special processing rules for certain projects consistent with a general plan but not outdated zoning.

Effective July 1, 2026, SB 79 allows qualifying transit-oriented housing near designated stops in covered cities, subject to statutory limits. Its application to unincorporated areas is deferred. Check the applicable transit map and eligibility criteria before relying on these provisions.

Separate CEQA, Coastal, and Federal Reviews

Under Public Resources Code § 21080, CEQA generally covers discretionary agency projects unless exempt. Ministerial projects are generally outside CEQA. Environmental clearance does not replace zoning approval.

The CEQA development approval guide explains environmental findings and agency review. Coastal-zone development may require a separate permit under Public Resources Code § 30600, subject to exemptions.

The National Environmental Policy Act (NEPA) applies when there is a qualifying federal action, not simply a local zoning application. Related requirements are addressed in environmental review.


4. Respond to Conditions, Violations, and Denials


Plan corrections, zoning violation notices, and final denials require different responses. Keep the written decision, hearing materials, and application record.


Identify What the Agency Actually Decided

Ask which ordinance provision a plan fails and whether revisions will resolve it. For enforcement notices, compare the allegation with permits, inspection records, and any lawful nonconforming use.

A previously lawful use may retain limited protection, but local rules may restrict expansion or end that status after discontinuance. Continued operation does not legalize an unlawful use.

If an agency demands off-site improvements or a dedication, examine the stated project impact and legal basis separately from the permitted-use question.

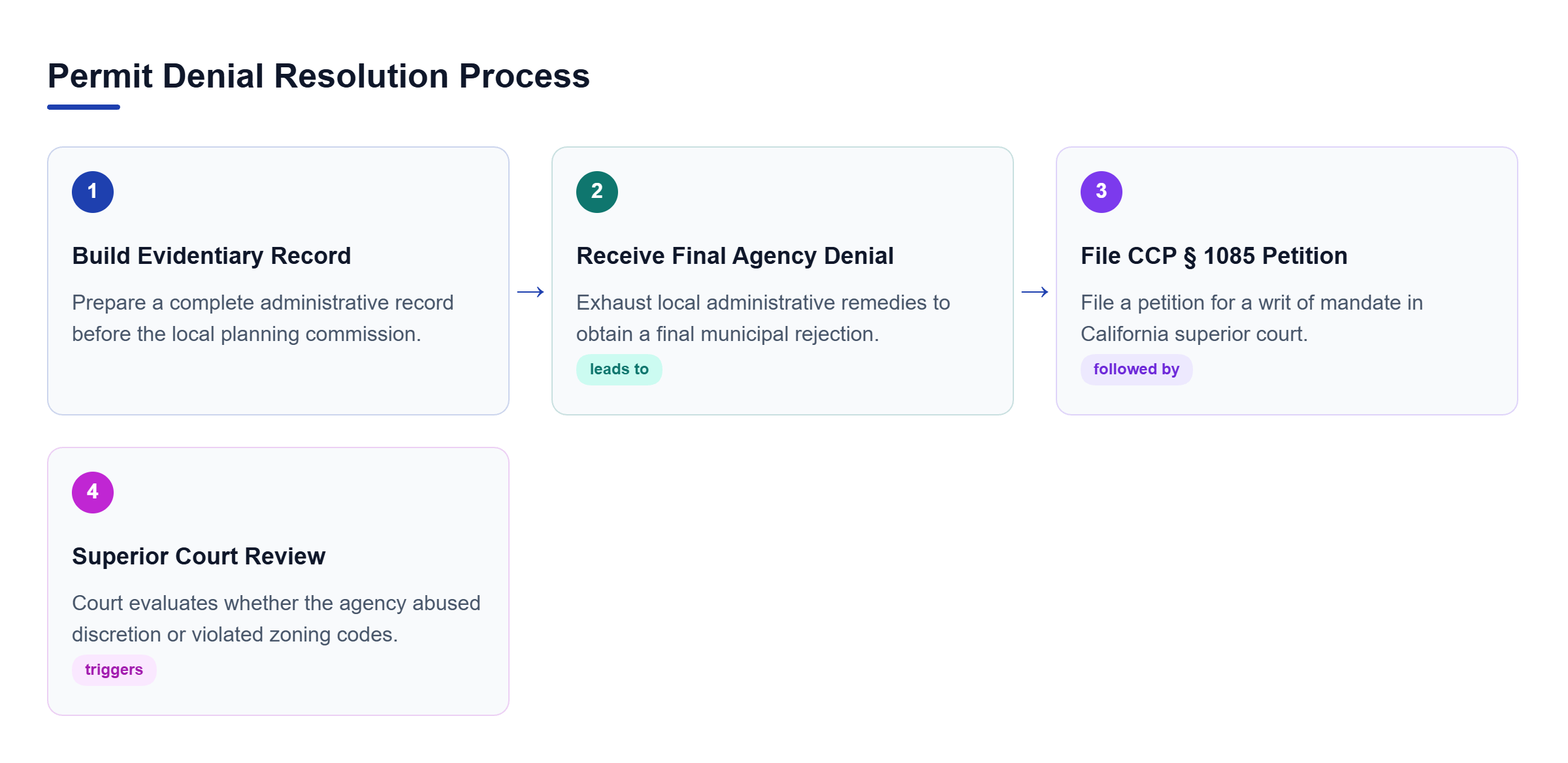

Preserve Appeal Rights and Filing Deadlines

Check the local ordinance for the appellate body, filing procedure, and deadline. Preserve objections raised at hearings because Government Code § 65009 may limit later arguments to issues presented during a properly noticed hearing.

Code of Civil Procedure § 1094.5 governs judicial review of certain final administrative decisions following legally required evidentiary hearings. Section 1085 addresses different writ claims.

Government Code § 65009 imposes a 90-day filing and service limit for specified land-use challenges, including certain CUP and variance decisions. Exceptions and triggering events matter. CEQA and other claims may have different deadlines.


5. Frequently Asked Questions


Can a Purchase Contract Depend on Zoning Approval?

Yes. A contract may identify the necessary approval, application responsibilities, deadline, and rights if permission is denied. It should also state who pays for studies and whether the buyer may withdraw if approval conditions make the project impractical. The contingency binds the parties, not the agency.

Does a Conditional Use Permit Transfer with the Property?

A CUP often runs with the land, but its conditions, expiration terms, and local rules must be checked. Changes in the operator, activity, or intensity may require further approval even when ownership remains unchanged.


22 Sep, 2026


The information provided in this article is for general informational purposes only and does not constitute legal advice. Prior results do not guarantee a similar outcome. Reading or relying on the contents of this article does not create an attorney-client relationship with our firm. For advice regarding your specific situation, please consult a qualified attorney licensed in your jurisdiction.
